This is a practical document that organizes the review process of the "New Center" opening project and the corresponding hierarchical structure of data and folders on the PC. The entire story from concept to suspension, restart, and production is visualized.

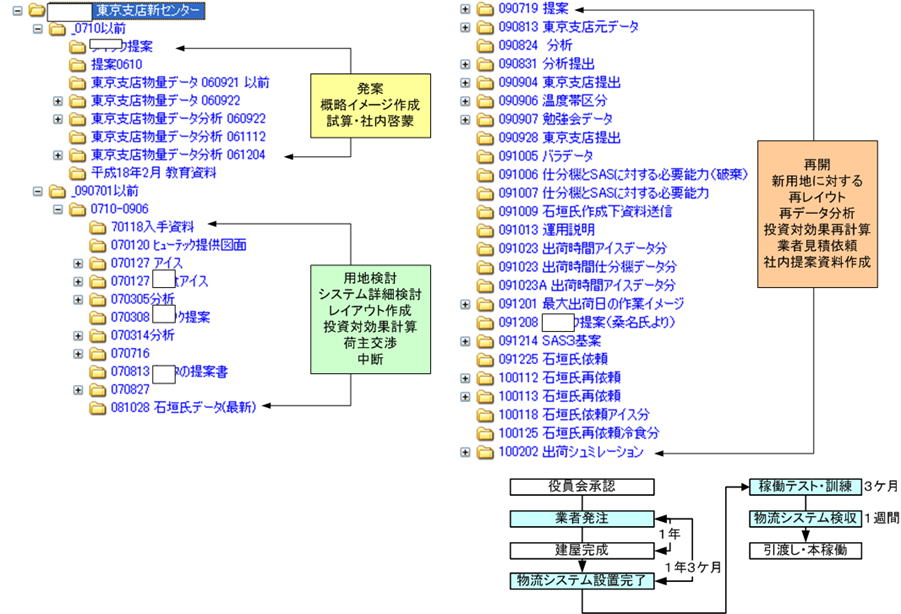

This is a project transition diagram using the actual folder hierarchy of "Tokyo Branch New Center".This diagram clearly documents how building a large-scale distribution center is a long and complex process.
season: _Before 0710(Around 2006-2007)
Implementation details:Proposal, creation of overall outline image, rough estimate, internal consensus building.
data:Analysis of past physical data, educational materials, and initial proposals.
season: 0710-0906(October 2007 - June 2009)
Implementation details:Site study, detailed system study, ROI calculation, shipper negotiations.
result:Temporarily suspended due to inconsistent conditions.
season: 090719-100202(July 2009 - February 2010)
Implementation details:Resumption at new site, layout re-creation, SAS/temperature zone verification, shipping simulation.
Standard construction lead time is approximately 1 year and 6 months to 1 year and 7 months from board approval (approval ➔ order ➔ 1 year construction ➔ system implementation ➔ testing ➔ actual operation).
This is a "promotion system diagram (project system diagram)" for opening and renewing a distribution center.

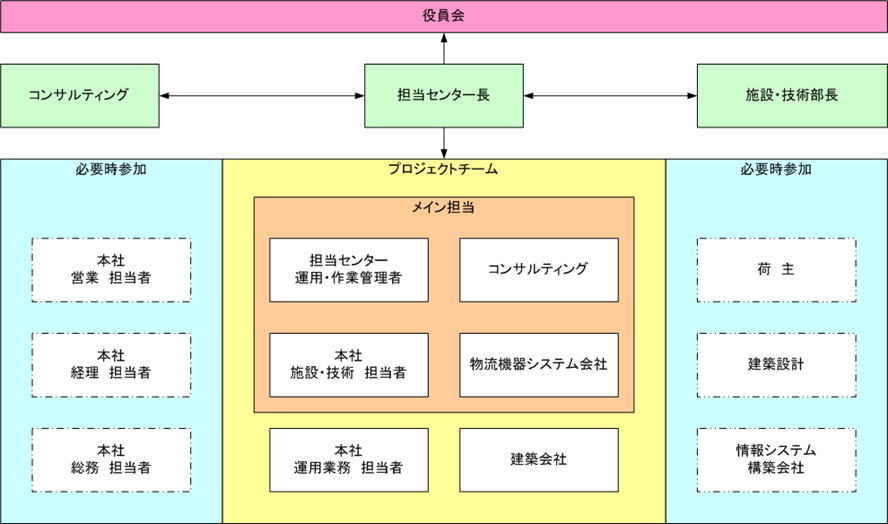

This diagram represents an ideal "promotion system diagram" for a logistics center opening project.You can see the structure that allows for both speed of decision-making and ensuring expertise.
| classification | Constituent members | Role/participation timing |
|---|---|---|
| Internal support (left side) | ・Head office sales person ・Head office accounting person ・Head Office General Affairs Person |
・sales:Contract conditions and revenue adjustment with shippers ・accounting:Budget management, asset recording, and depreciation support ・general affairs:Land contract, legal procedures, labor environment improvement |
| External partner (right side) | ・Shipper ・Architectural design ・Information system construction company |
・Shipper:Coordination of delivery conditions, packaging, and shipping requirements ・Architectural design:Creation of basic design/detailed design ・System company:WMS collaboration/IT infrastructure development |
This is a phase-by-phase promotion process (stage gate) and practical rules for building a logistics center and introducing a system.

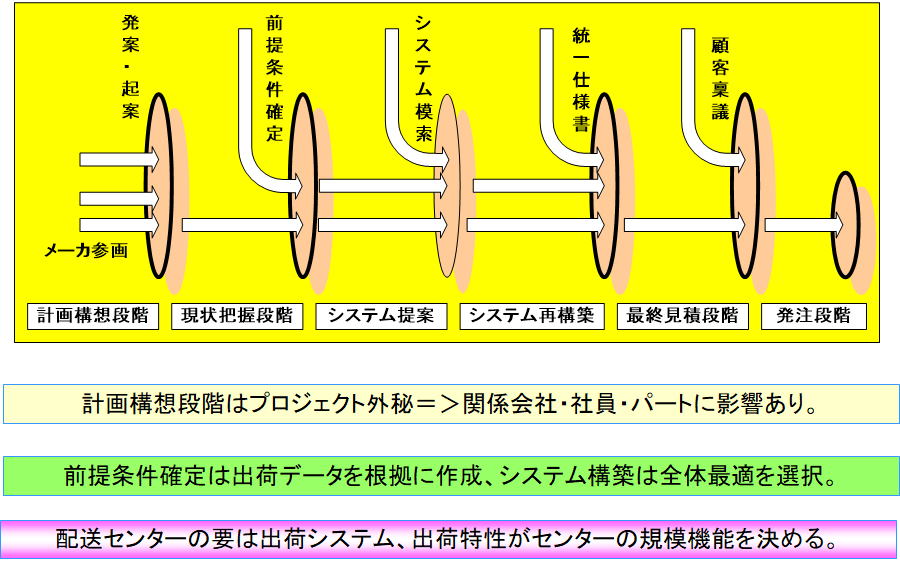

This is a conceptual diagram that expresses the steps of planning progress using six phases and "stage gates".A filtering mechanism is demonstrated to ensure that complex projects move forward.
| stage (phase) | Main action points at the gate |
|---|---|
| 1. Planning stage | Idea/draft/manufacturer participation:This is the stage where we develop an initial concept and begin to involve major equipment manufacturers. |
| 2. Stage of understanding the current situation | Prerequisites confirmed:This is the stage of identifying the current quantity and operation and solidifying the prerequisites for the plan. |
| 3. System proposal | System exploration:The stage of exploring and selecting options such as necessary functions and material handling (automated equipment). |
| 4. System reconstruction | Uniform specifications:This is the stage where proposals from each company are compared and integrated and incorporated into a unified specification (RFP). |
| 5. Final estimate stage | Customer approval:The final amount and conditions are finalized, and the final settlement and approval process is completed by the shipper and within the company. |
| 6. Ordering stage | Final order:The stage of signing a contract and moving on to actual manufacturing and construction. |
① Information management and risk care
"The project is confidential at the planning stage => Affects affiliated companies, employees, and part-timers."
*Since base integration and reorganization have an impact on the field, information management is essential at an uncertain early stage.
② Data-driven and overall optimization
``Prerequisites were determined based on shipping data, and overall optimization was selected for system construction.''
*We eliminate emotion and optimize the entire supply chain based on quantitative shipping data.
③ Essence of building a logistics center
"The core of a distribution center is the shipping system, and the shipping characteristics determine the size and function of the center."
*The key to success is to design (reverse design) based on shipping characteristics (number of delivery destinations, shipping volume, waves, etc.).
The process from requirements definition to system selection to vendor request for quotation (RFP) and the most important principles for site development.

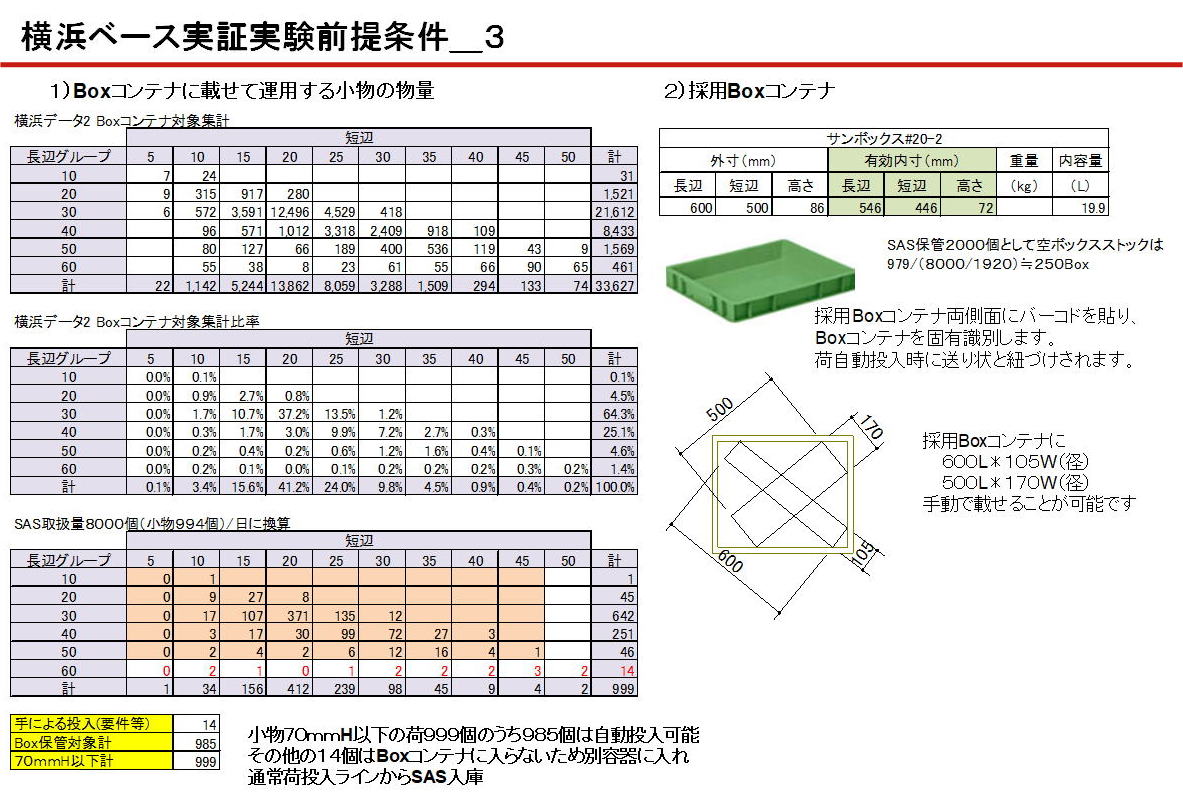

The figure shows detailed data analysis (quantification of STEP 1 in the scope of study) for actually operating small items in a Box container as a prerequisite for the Yokohama-based demonstration experiment.
💡 The most important principle in base development (inside-out)
"For the distribution center, decide on the logistics system first and then adjust it to the building specifications."
If the box (building) is built first, efficient material handling will be difficult due to column pitch and ceiling height.The golden rule is to design the contents (system/flow line) in advance and then create a box that encloses it.
This is a comprehensive roadmap that integrates the negotiation progress process (sales/technical role shift) and planned progress.

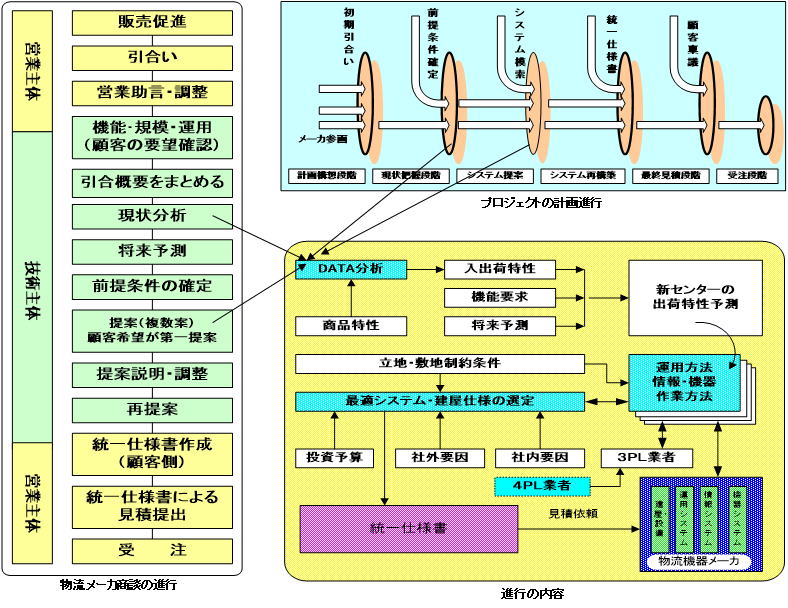

This comprehensive roadmap is drawn by completely linking three axes: ``progress of logistics manufacturer business negotiations (on the left),'' ``project planning progress (top right),'' and ``content of progress (bottom right).'' This is a master plan that provides an overview of the entire project.
Sales promotion ➔ Inquiry ➔ Sales advice/coordination.
Sales will act as a point of contact and identify issues and initial needs.
Analysis of current situation ➔ Future forecast ➔ Determination of prerequisites ➔ Proposal.
Engineers analyze the data and create a concrete system plan.
Creation of unified specifications ➔ Submission of quotation ➔ Acceptance of orders.
After finalizing the specifications, we will make final adjustments and sign a contract.

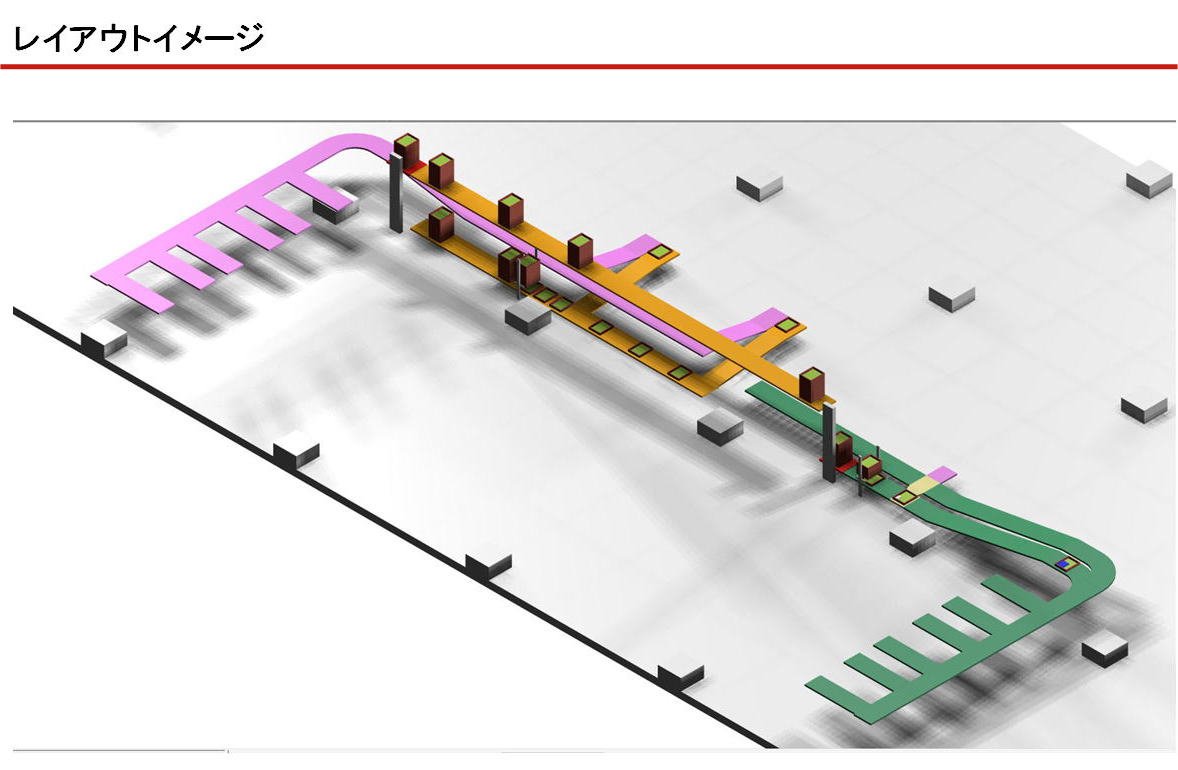

This is an approach that changes the mindset from "conflict of opinions and confusion (scalar)" in the early stages of a project to "overall optimization (vector)" where everyone is heading in the same direction.

| step | state (concept) | Features/Internal situation |
|---|---|---|
| early stage | scalar (Size only, orientation varies) |
-Each person makes different claims and is fixated on departmental profits (local optimization). |
| Promotion/unification | Organize, adjust, visualize | Organize and visualize information and make adjustments based on objective grounds. |
| Attainment stage | vector (There is a size and a clear direction) |
・Unification of purpose and means has been completed, and a shift has been made to "overall optimization." |
🔑 Requirements for vectorizing teams
“Objectivity that allows a third party to evaluate and the ability to express images is required.”
Quantitative logistics data (objectivity) and illustrations and 3D visualization (expressiveness) that allow everyone to share the mental image are the keys to consciousness integration.

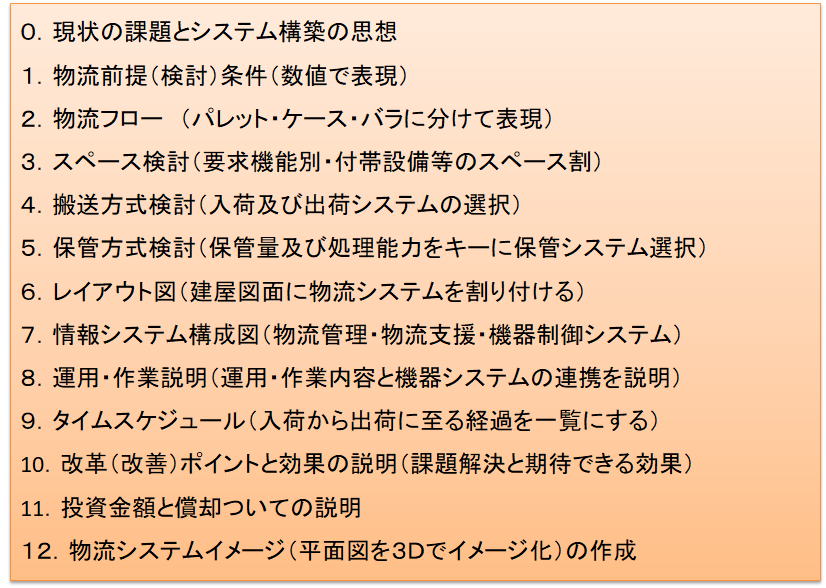

These are the 13 structural requirements of the "basic plan" that should be approved by management (approval) and included in the RFP for vendors.
📌 Practical summary
By having these 13 items in place, it will be possible to create a situation in which ``management can make investment decisions,'' ``the field can visualize the operation,'' and ``vendors can create accurate estimates.''
